Melrose Promenade

Updated December 16, 2021

What's happening now?

We completed design on the Melrose Promenade project to create a safer, more inviting street for everyone. We're now in the process of hiring a construction contractor. We expect to start construction in early 2022 and to continue into fall.

Help us understand your needs during construction! Please complete this survey so we can keep you in the loop and work to minimize impacts to neighbors as much as possible.

See this poster for the latest including zoomed-in images of the design at Melrose and Denny, Olive, Pine, and Pike.

Graphic showing we're in preconstruction phase

Stay informed on what to expect during construction

Check out our construction email archive for the latest and sign up for email updates here. See below for more information on typical construction activities. Once construction begins, we will send weekly email updates with the latest information on planned construction activities and what neighbors can expect.

Background

Built atop a high retaining wall, Melrose Ave is a key walking/biking connection. The construction of I-5 created a barrier between Capitol Hill and downtown that project neighbors have envisioned reconnecting through the "Melrose Promenade."

Melrose Ave is a key walking and biking connection in our citywide network and is included in our Bicycle Master Plan. Part of the project area is a designated pedestrian zone that will provide safe and accessible walking connections.

Currently, the streets can be difficult to cross, some sidewalks and pavement are damaged, and drivers are exceeding the speed limit. Between 2013 and 2018, there were a total of 141 reported collisions on Melrose Ave between Roy St and University St. All but 1 of the serious injury collisions involved someone walking or biking between Denny Way and Pike St.

Capitol Hill is one of the densest neighborhoods in the Puget Sound region and continues to grow. The Melrose Promenade will connect community members with major destinations in the neighborhood and routes to First Hill and Downtown. The project area includes high-density residential and mixed-use communities, and major employment centers near the south end of the project including medical centers, colleges, and the downtown business district. Currently, 37% of households in the Melrose Promenade project area are car-free. Constrained on-street parking supply, expensive off-street parking, nearby mass transit, and the density of housing and jobs in the neighborhood can make owning a car expensive and inconvenient - or unnecessary for many. This project aims to improve walking and biking connections so they are more attractive and convenient.

This project is a foundational step toward the community's "Melrose Promenade" vision by improving the walking and biking experience along Melrose Ave from E Roy St to University St.

Pike pedestrians

Project Area

We're building speed humps, curb ramps, curb bulbs, a raised intersection, and bike lanes in sections, as well as repairing damaged pavement and sidewalks on Melrose Ave between E Roy St and University St.

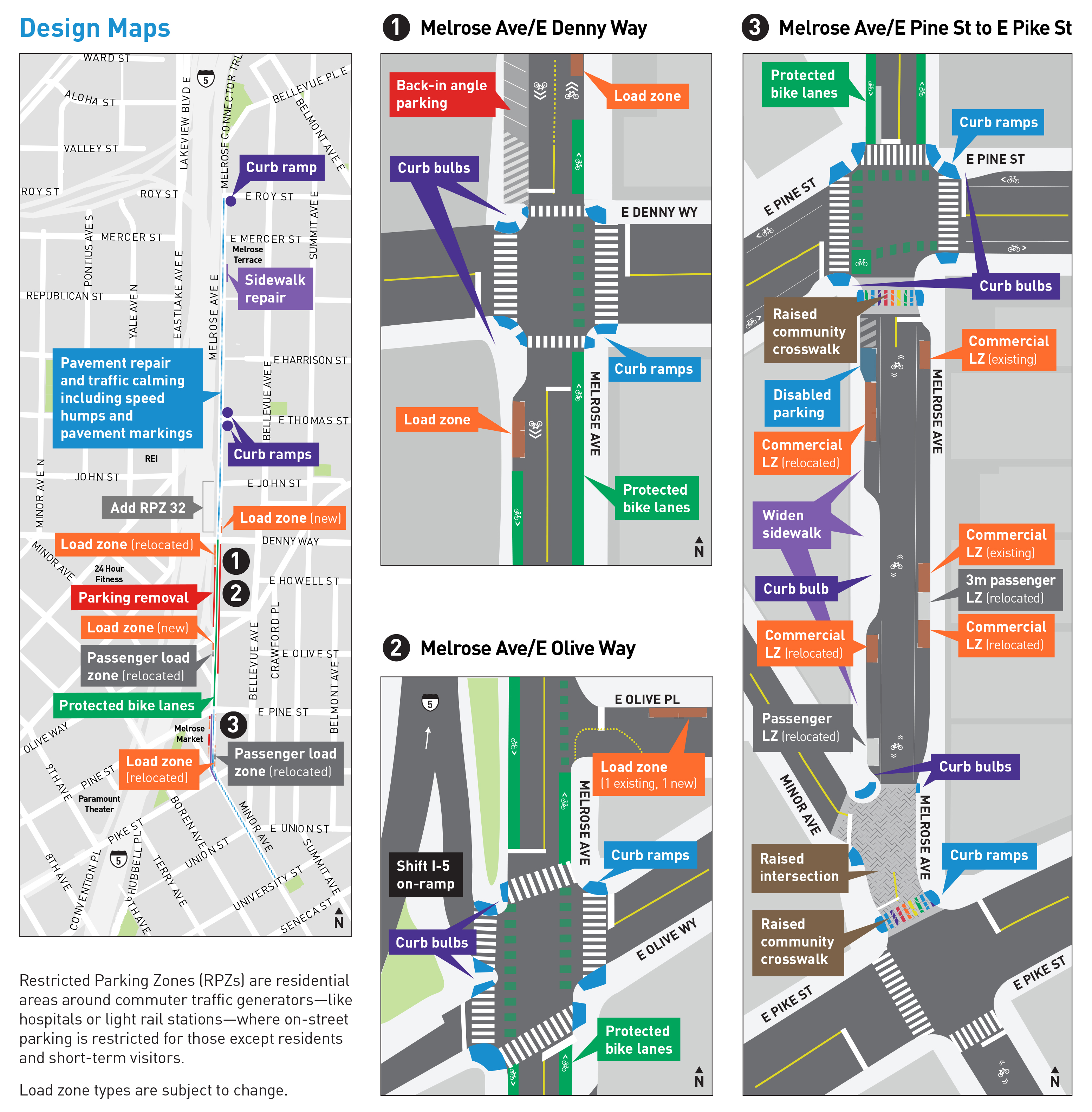

Melrose project design maps

See this poster for a PDF of design the map image above.

Outreach & Project Design

In 2018 and 2019, we conducted outreach with project neighbors and collected input on the project design. We hosted an open house with an online survey and held meetings with neighbors and community members on early design concepts. Materials from these outreach activities, including summaries on what we heard, can be found in the Documents section below. We finalized project design in 2020 and will begin construction in early 2022.

Key project elements include:

  • Protected bike lanes between E Pine St and E Denny Way
  • Intersection improvements at E Pike St, E Pine St, E Denny Way, and E Olive Way, including:
    • New raised intersection and at Melrose Ave and E Pike St
    • Raised community crosswalks at E Pike St and E Pine St
    • New curb bulbs and crosswalks at the intersection of E Olive Way and Melrose Ave to improve safety at the I-5 on-ramp entrance
  • Traffic calming including speed humps and pavement markings
  • Pavement and sidewalk repair, including installing a wider sidewalk on the west side of Melrose Ave between E Pike St and E Pine St
  • Curb ramp improvements
  • New and relocated load zones
  • Changes to on-street parking, including some parking removal between E Pine St and E Denny Way, new back-in angle parking and a Restricted Parking Zone north of E Denny Way

See this poster for a PDF of the project design the map.

People at the open house event

Community members and project staff review design concepts at a public meeting.

What to Expect During Construction

We are in the process of hiring a construction contractor and will have more information soon on what people can expect. Construction will begin in early 2022 and continue into fall 2022. We will send weekly emails once construction begins with the latest information on what you can expect. You can sign up for eamil updates here

Typical construction hours are weekdays from 7 AM - 5 PM, with occasional nighttime and weekend work. We are restricting weekend construction between E Pike St and E Pine St in order to minimize impacts to the business and retail district.

During construction, people can expect:

  • Temporary lane and street closures for people driving. Detours will be provided and signed.
  • Temporary sidewalk and crossing closures for people walking and rolling. Detours will be provided and signed.
  • Disruptions to on-street parking.
  • Noise, dust, and vibrations during work hours.
  • Construction equipment staged in the work area.
  • Pedestrian access will be maintained at all times to businesses and residences.

Funding

The total project budget (includes design and construction) is $4.3 million including a grant through the Federal Highway Administration covering $3 million of that budget. The project is also funded by the Levy to Move Seattle, a 9-year $930 million levy approved by voters in 2015.
