East Marginal Way Paving and Safety Project Overview

We're working to make improvements on East Marginal Way S from 1st Ave S to the Seattle/Tukwila city boundary. The project will repair the existing pavement, which is in poor condition. We are proposing safety improvements for people walking, biking, and taking the bus. This project will make it safer for you to get between Georgetown, South Park, Delridge, and Highland Park neighborhoods. It will also connect people biking between Tukwila, Downtown, and West Seattle.

If you want to learn more, call us at (206) 775-8719. If you need information about the project in another language, tell us your preferred language in English when you call. We offer translation and interpretation for free.

We are currently in the early design phase for this project. We are focusing on gathering feedback from the community as we further develop the safety enhancements.

Descripción general del proyecto de pavimentación y seguridad en East Marginal Way

Estamos trabajando para hacer mejoras en East Marginal Way S, desde 1st Ave S hasta el límite entre Seattle y Tukwila. El proyecto reparará el pavimento existente, que está en malas condiciones. Estamos proponiendo mejoras de seguridad para las personas que caminan, andan en bicicleta y toman el autobús. Este proyecto hará que sea más seguro para usted viajar entre los vecindarios de Georgetown, South Park, Delridge y Highland Park. Ademas, conectará a las personas que se desplazan en bicicleta entre Tukwila, el centro de Seattle y West Seattle.

Si desea más información, llámenos al (206) 775-8719. Si necesita información sobre el proyecto en otro idioma, díganos en inglés cuál es su idioma preferido cuando llame. Ofrecemos servicios de traducción e interpretación sin costo.

Actualmente estamos en la fase de diseño preliminar de este proyecto. Nos estamos enfocando en recopilar comentarios de la comunidad mientras seguimos desarrollando las mejoras de seguridad.

East Marginal Way 鋪路和安全專案概述

我們正在努力改善從 1st Ave S 到西雅圖/Tukwila 城市邊界的 East Marginal Way S。本專案將修復現有狀況不佳的路面。我們正在提議改善步行、騎自行車和乘坐公車的人們的安全。本專案將提升您在 Georgetown、South Park、Delridge 和 Highland Park 社區之間通行的安全性。它也將為騎自行車的人們提供連接 Tukwila、市中心和西西雅圖之間的通行路線。

如需了解更多資訊,請致電(206)775-8719。如需其他語言的專案訊息,請在致電時用英語告知我們您想要的語言。我們提供免費的翻譯和口譯服務。 我們目前正處於該專案的早期設計階段。我們正專注於收集社區的回饋意見,以進一步完善安全改善措施。

Tổng Quan về Dự Án Lát Đường và An Toàn Đường East Marginal Way

Chúng tôi đang thực hiện các cải tiến trên đường East Marginal Way S từ đường 1st Ave S đến ranh giới thành phố Seattle/Tukwila. Dự án sẽ sửa chữa mặt đường hiện tại đang trong tình trạng xuống cấp. Chúng tôi đang đề xuất các cải tiến an toàn cho người đi bộ, đi xe đạp và đi xe buýt. Dự án này sẽ giúp quý vị di chuyển an toàn hơn giữa các khu phố Georgetown, South Park, Delridge và Highland Park. Dự án cũng sẽ kết nối người đi xe đạp giữa Tukwila, Downtown và West Seattle.

Nếu quý vị muốn tìm hiểu thêm, vui lòng gọi cho chúng tôi theo số (206) 775-8719. Nếu quý vị cần thông tin về dự án bằng ngôn ngữ khác, vui lòng cho chúng tôi biết ngôn ngữ quý vị muốn sử dụng bằng tiếng Anh khi gọi. Chúng tôi cung cấp dịch vụ biên dịch và thông dịch miễn phí.  Chúng tôi hiện đang trong giai đoạn thiết kế ban đầu cho dự án này. Chúng tôi đang tập trung thu thập phản hồi từ cộng đồng khi chúng tôi tiếp tục phát triển các cải tiến về an toàn.

이스트 마지널 웨이(East Marginal Way) 포장 작업 및 안전 프로젝트 개요

교통국은 1st Ave S에서 시애틀/터퀼라(Tukwila) 시 경계 사이의 East Marginal Way를 개선하는 작업을 계획하고 있습니다. 해당 프로젝트는 상태가 좋지 않은 기존의 도로 포장을 수리합니다. 저희는 도보, 자전거, 버스를 이용하는 사람들의 안전을 개선하기 위한 조치를 제안하고 있습니다. 이 프로젝트를 통해 조지타운, 사우스 파크, 델리지, 하이랜드 파크 지역 간 이동이 더욱 안전해질 것입니다. 또한 터퀼라, 다운타운, 웨스트 시애틀 간에 자전거로 이동하는 사람들을 연결해 줄 것입니다.

자세한 내용은 (206) 775-8719로 문의하십시오. 다른 언어로 해당 프로젝트에 대한 정보가 필요한 경우, 전화하실 때 선호하는 언어를 영어로 알려주십시오. 번역 및 통역 서비스를 무료로 제공해 드리고 있습니다.

현재 이 프로젝트는 초기 설계 단계에 있습니다. 교통국은 안전 강화 사항을 더욱 발달시켜가며 지역 사회로부터 피드백을 수집하는 데 주력하고 있습니다.

イースト・マージナル・ウェイ舗装および安全性向上プロジェクトに関する概要

シアトル市は、East Marginal Way Sの1st Ave Sからシアトル/タクウィラ市境までの区間の改良工事を進めています。本プロジェクトでは、劣化した既存の路面の修繕します。また、歩行者、自転車利用者、バス利用者の安全性を高める対策を提案します。このプロジェクトにより、ジョージタウン、サウスパーク、デルリッジ、ハイランドパーク各地区の間をより安全に移動できるようになります。さらに、タクウィラ、ダウンタウン、ウエストシアトル間の自転車移動も可能になります。

詳細については、‪(206) 775-8719までお電話ください。本プロジェクトに関する情報を英語以外の言語で受け取るには、お電話の際に英語でご希望言語をお知らせください。無料で翻訳および通訳をご利用いただけます。

現在、本プロジェクトは設計の初期段階にあります。私たちは、安全性向上策のさらなる強化に向け、地域の皆さまからのご意見の収集に力を入れています。

Updated October 2025

What's Happening Now?

Thank you to everyone who contributed feedback to our early design outreach period via the online survey, online open house, pop-up event, stakeholder meetings, or emails between August - October. We’re now sharing the feedback with our designers and summarizing what we heard.

In the coming weeks, we’ll post the early design outreach summary online and we’ll share the updated designs later this year.

The feedback we received made it clear that people want to know more about key project design elements. We refreshed the project webpage with information on the southbound lane reduction and frequently asked questions. The project will also make street lighting improvements along the corridor. We’ll share more about our lighting plans soon.

If you have any questions, please email our project inbox at emarginalpavingandsafety@seattle.gov.

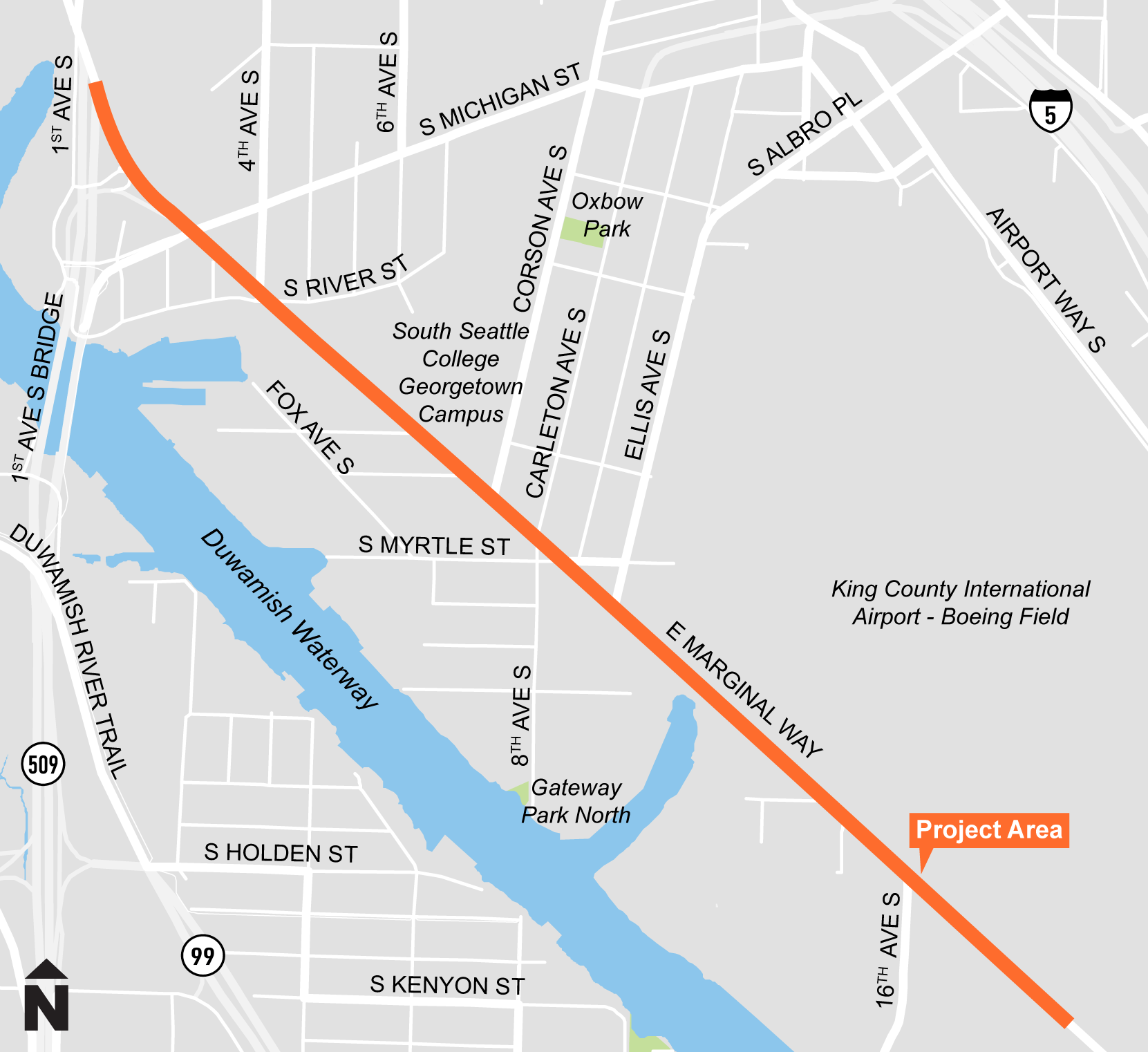

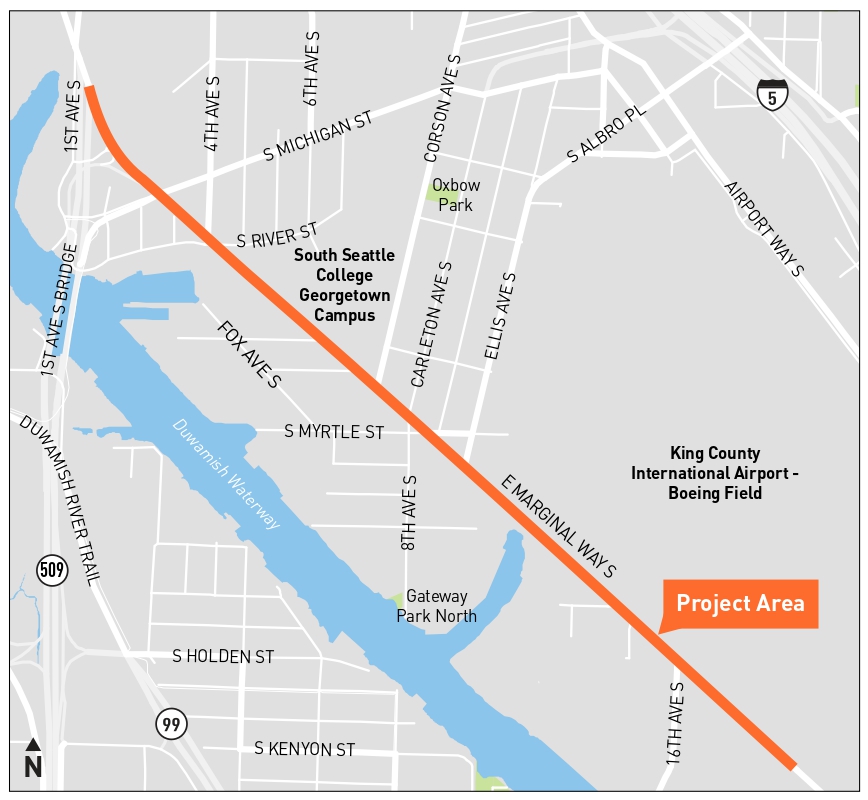

Project Area Map

Project limits map showing E Marginal Way from 1st Ave S to Approximately 16th Ave S

Project Improvements

The Seattle Department of Transportation (SDOT) is repaving East Marginal Way S from 1st Ave S to the Seattle/Tukwila city line. Our paving and safety improvements project will restore the pavement, which is in poor condition, to meet the needs of freight and transit. This work will extend the lifespan of the street by 10-20 years. It will also make it more comfortable for you to travel along East Marginal Way S.

During the project's planning phase, we reviewed recommendations from past planning efforts such as the Georgetown Mobility Study, the Seattle Transportation Plan, and the Duwamish Valley Action Plan. People want safer crossings on East Marginal Way S, bike lanes that are separated from cars, and for bike lanes to connect to other bike paths. The project proposes safety enhancements along the corridor to:

  • reduce conflicts by separating cars, trucks, and buses from people walking, biking, and rolling
  • slow down vehicle turning movements
  • make bicycling, walking, and rolling along the corridor safe and comfortable for people of all abilities

The proposed safety improvements are outlined below and can be viewed on the cross sections and key area graphics. Please visit the Project Library section of the webpage to review the early design roll plot.

Freight

East Marginal Way S is a busy freight corridor and this project will preserve access. In addition to repaving the street, freight improvements in early design include:

  • Maintain freight operations, including over legal limits movements
  • Separate vehicles from pedestrians and bicyclists along the corridor
  • Upgrade signal heads to improve visibility
  • Add dedicated signal turn phases to eliminate conflicts between users
  • Fix or replace traffic sensors to improve signal operations
  • Install drainage improvements

Safety

Because safety on East Marginal Way S was one of the top concerns we heard from the community, our proposed Vision Zero safety improvements include:

  • Redesign East Marginal Way S and 4th Ave S intersection to reduce size of southeast corner radius
    • This will slow down vehicle turning speeds and shorten pedestrian crossing distance
    • We will install a widened curb for trucks to navigate turning movement
  • Install hardened centerlines on side streets to slow down turning movements
  • Upgrade signals along the corridor to improve safety
  • Install concrete curb bulbs at key intersections to increase visibility and slow down turning movements
  • Southbound reduction from two lanes to one lane from 4th Ave S to Ellis Ave S, which is adjacent to the southern border of Georgetown's residential neighborhood

Biking

To help meet our climate goals, close gaps in our bike network, and separate drivers from people biking along the corridor, the early design bike improvements include:

  • Construct a 10-foot wide, two-way protected bike lane with precast concrete barrier along the north side of East Marginal Way S between S River St and Corson Ave S
  • Construct an 11-foot wide, sidewalk level Shared Use Path along the north side of East Marginal Way S between Corson Ave S and the Flume Trail as a continuation of the path installed by the Georgetown to South Park Safety project
  • Install directional protected bike lanes with high curbs from 16th Ave S to the approach of the Seattle/Tukwila city line
  • Install two-way bike crossing at south leg of East Marginal Way S and 4th Ave S for future bike route on S River St
  • Install two-way bike crossing at north leg of East Marginal Way S and Carleton Ave S/8th Ave S
  • Upgrade signals with dedicated turn phases to support the new bike lanes and reduce conflicts

Walking and Rolling

To improve walkability and neighborhood connections, the pedestrian improvements in early design include:

  • Repair sidewalks along the corridor outside of the area where a Shared Use Path is proposed
  • Inspect and reconstruct curb ramps to make them complaint with the Americans with Disabilities Act (ADA)
  • Install Accessible Pedestrian Signals, which provide auditory, visual, and vibrotactile information, along the corridor
  • Install curb bulbs to reduce crossing distances and improve visibility at key intersections

Transit

In addition to repaving East Marginal Way S to meet the needs of transit and improve service, bus improvements in early design include:

  • Bus bulb with shelter and lighting for the southbound stop at S Webster St/14th Ave S
  • Bus stop upgrades for the northbound stop at S Ellis St
  • Repair sidewalks and install ADA curb ramps along the corridor to improve access to bus stops

Key Project Areas

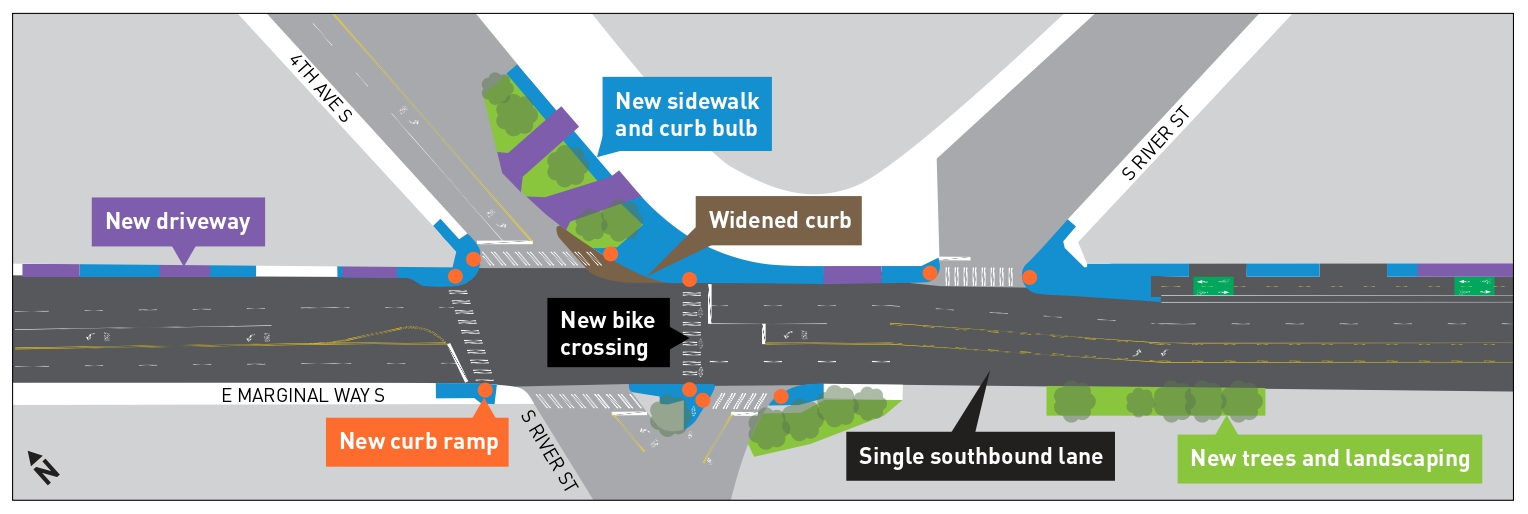

4th Ave S and S River St
4th Ave S and S River St design

Corson Ave S to Ellis Ave S
Corson Ave S to Ellis Ave S design

14th Ave S to 16th Ave S
 14th Ave S to 16th Ave S design

Learn more about the project

4th Ave S to Corson Ave S

4th Ave S to Corson Ave S cross section

Corson Ave S to Carleton Ave S
Corson Ave S to Carleton Ave S cross section

Carleton Ave S to S Ellis St
Carleton Ave S to Ellis Ave S cross section

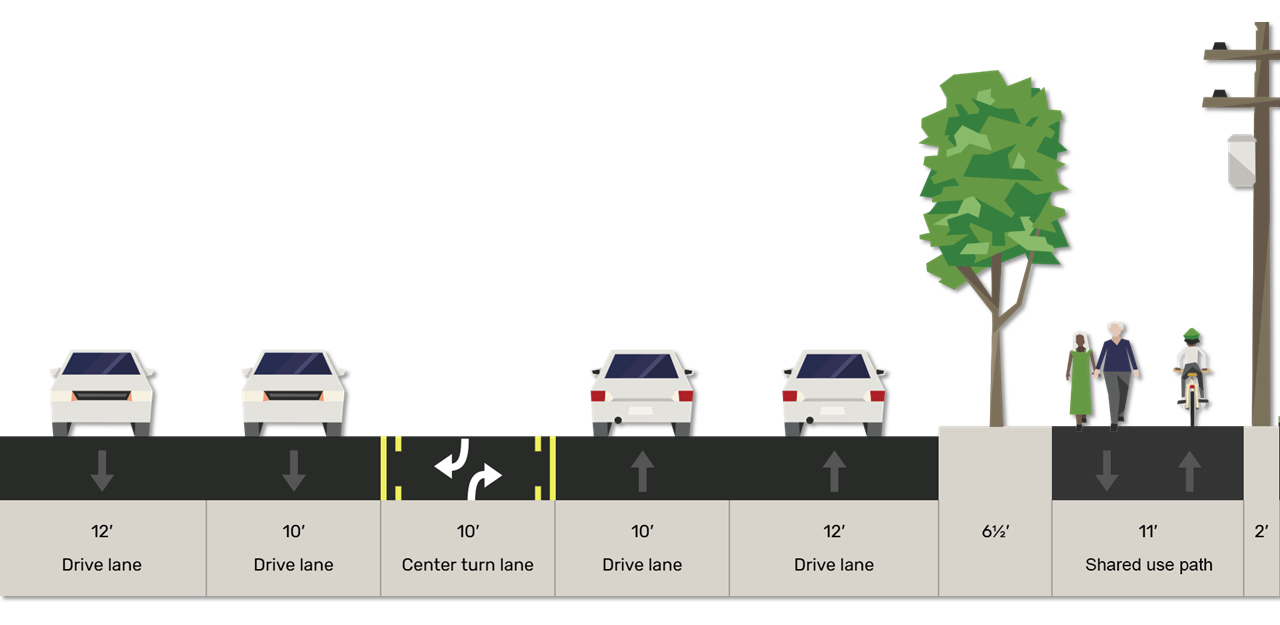

Ellis Ave S to 16th Ave S
Ellis Ave S to 16th Ave S cross sections

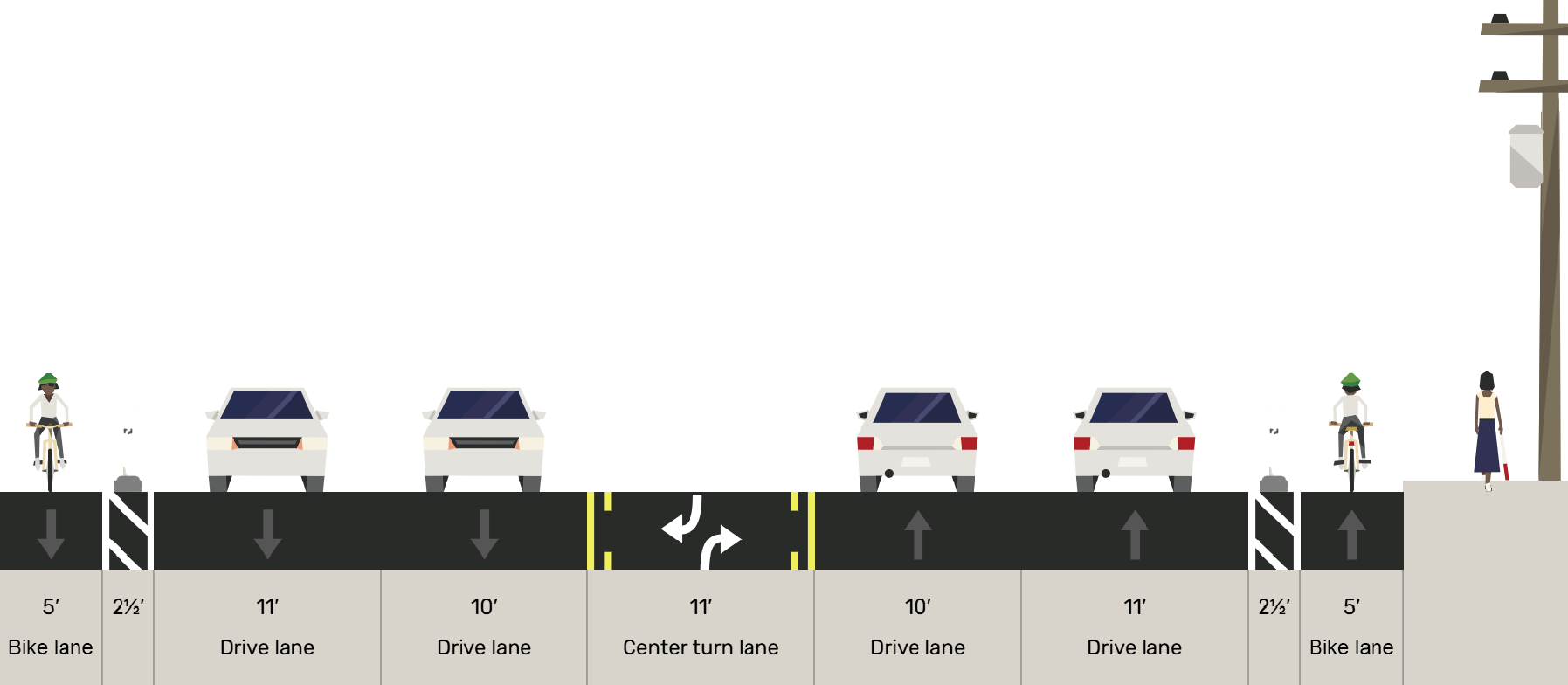

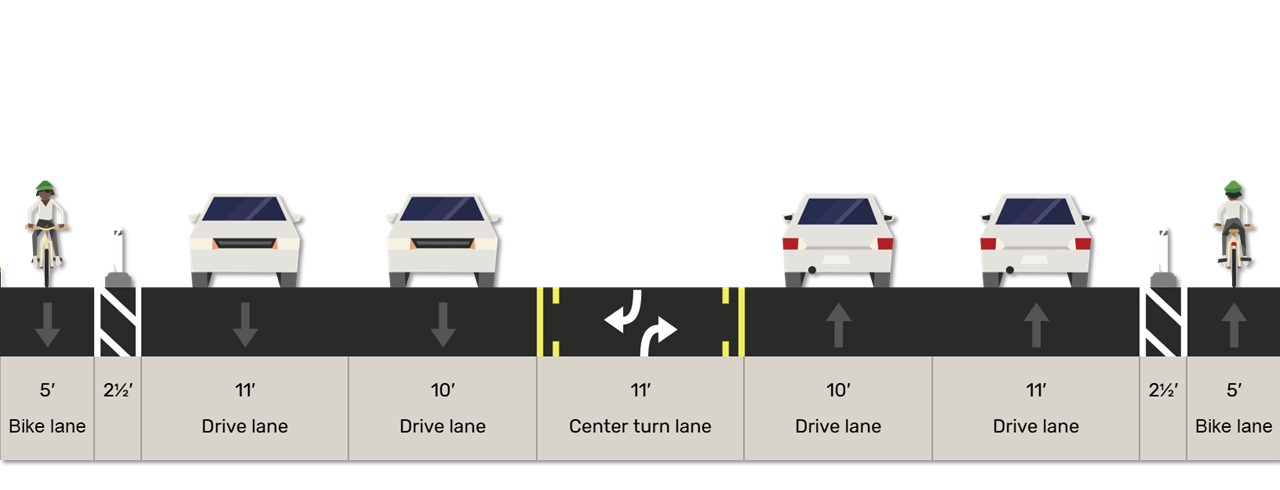

16th Ave S to city boundary
16th Ave S to city boundary cross section

Street Redesign

Moving freight and goods remains a priority for this Major Truck Street that serves port facilities, cargo yards, and major businesses. This distinction and the importance of maintaining freight reliability was carefully considered as we developed the new street design.

The new design enhances safety for everyone by encouraging safer driving speeds, improving visibility at crossings, and making the movements of all travelers more predictable. The project further separates travelers who walk, roll, and bike from faster-traveling traffic. The design also improves bike connections between Duwamish Valley neighborhoods and West Seattle.

Southbound Lane Reduction

During the planning process, we collected data on E Marginal Way S and determined the removal of one southbound lane from 4th Ave S to S Ellis St would not reduce the level of service for freight. This lane reduction would allow us to extend the shared use path to Corson Ave S and install protected bike lanes up to S River St. We are adding a bike crossing at the south leg of the E Marginal Way S / 4th Ave S / S River St intersection. The bike crossing will tie-in with a planned SDOT bike project on S River St that will connect with the 1st Ave S Bridge Trail.

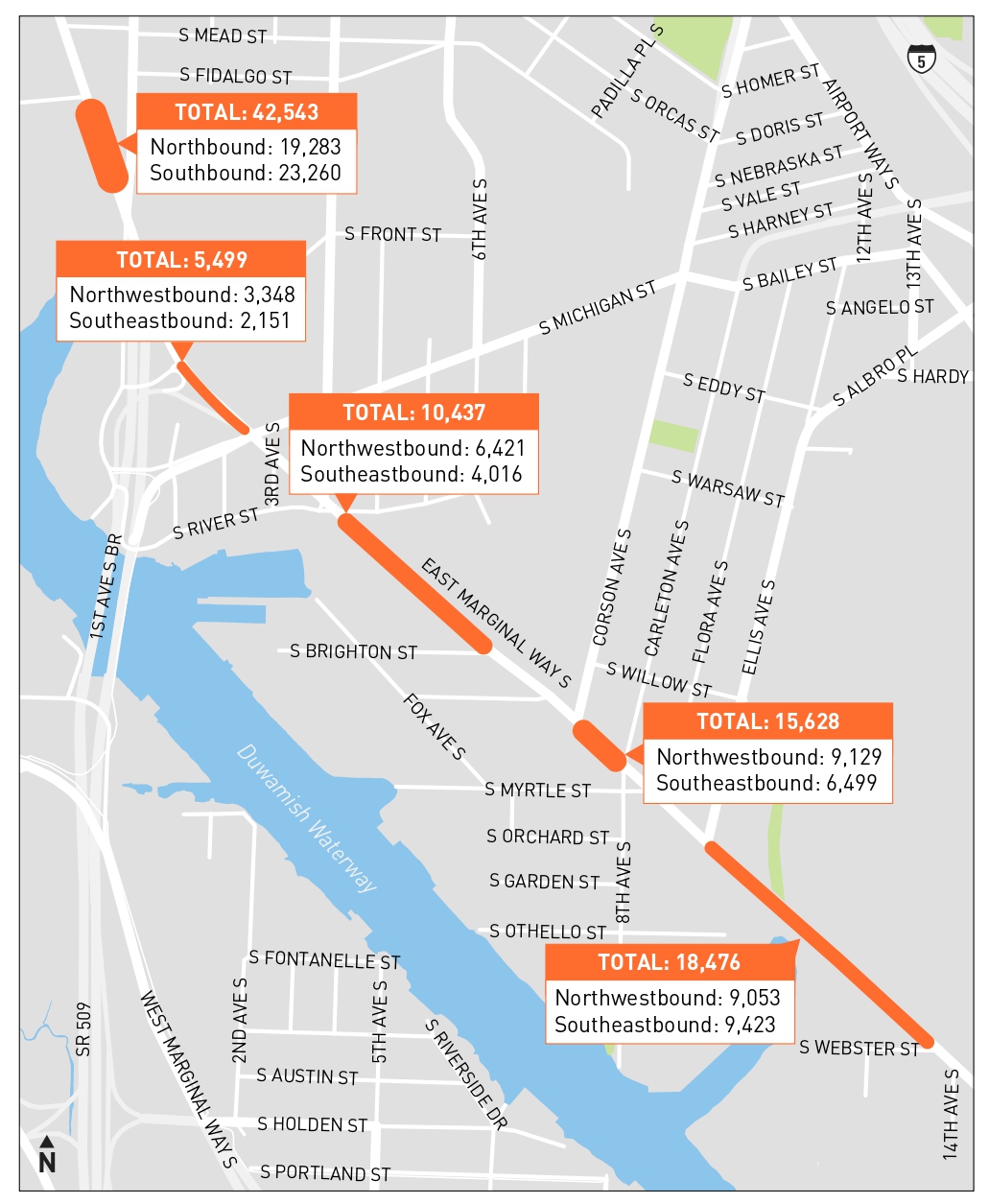

Anticipated delays per vehicle along E Marginal Way S based on our traffic analysis.

The numbers represent average daily traffic (vehicles) based on 7-days. (SDOT traffic data)

Anticipated delays per vehicle along E Marginal Way S based on our traffic analysis:

  • S Michigan St
    • No anticipated delays
  • 4th Ave S
    • AM Peak – 1 second delay
    • PM Peak – 10 second delay
  • Corson Ave S
    • AM Peak – no anticipated delays
    • PM Peak – 1 second delay
  • Carleton Ave S
    • AM Peak – 1 second delay
    • PM Peak – 1 second delay
  • Ellis Ave S
    • AM Peak – 4 second delay
    • PM Peak – 3 second delay
  • 14th Ave S
    • AM Peak – no anticipated delays
    • PM Peak – 4 second delay
  • 16th Ave S
    • AM Peak – 1 second delay
    • PM Peak – 1 second delay

What bike and pedestrian facilities will this project build connections to?

  • The SDOT Bike Web Map shows all of Seattle’s bike facilities. This project will improve access to the 1st Ave S bridge trail, the Duwamish River trail, the Georgetown to South Park trail, and the Georgetown to Downtown bike lanes which connect to the SODO trail into the downtown bike network.
  • Our project includes directional protected bike lanes with tall curbs from 16th Ave S to the approach of the Seattle/Tukwila city line. We are working with the City of Tukwila to ensure our design plans are compatible with their plans. This project will improve access to and from the Green River Trail but does not connect directly to it.
  • As part of a separate planned project that will create a bike route along S River St and connect to the 1st Ave S Bridge Trail, SDOT will install a two-way bike crossing at the south leg of East Marginal Way S and 4th Ave S.

Why does SDOT want bike lanes on freight corridors? Wouldn't bike lanes on other streets be safer and better for traffic?

  • This project builds connections to existing and future bike and pedestrian routes to make it safer for people to walk and roll where they are already traveling or where future developments will route them.
  • E Marginal Way S offers the most direct routes to existing transit stops and existing bike and pedestrian facilities like the 1st Ave S bridge trail, the Duwamish River trail, the Georgetown to South Park trail, and the Georgetown to Downtown bike lanes which connect to the SODO trail into the downtown bike network.

How many people walk and bike in this area today? How much to you expect that to increase with this project?

  • We did not conduct a bike and pedestrian traffic count in this area. This paving project triggered a redesign of the corridor to be in compliance with the city’s Complete Streets Policy (2007). The policy directs SDOT to design streets for people walking, rolling, biking, taking transit, and persons of all ages and abilities, while promoting safe operations for all users.
  • This isn’t a popular bike route currently because there isn’t an existing bike facility that feels comfortable for most riders. Once this project is built, we expect more people will walk, roll, and bike along the corridor as they become aware of the new travel options and more comfortable with using them. These numbers will grow as we continue to build these options throughout the City and especially in South Seattle.

How will this project design safe routes for cyclists and pedestrians through intersections and driveways?

For people walking and rolling through intersections, early design enhancements along the corridor, include:

  • Inspecting and reconstructing curb ramps to make them complaint with the Americans with Disabilities Act (ADA)
  • Installing Leading Pedestrian Intervals, which is a traffic signal timing strategy that allows pedestrians to enter the crosswalk 3-7 seconds before vehicles receive a green light, enhancing pedestrian safety and visibility
  • Installing Accessible Pedestrian Signals, which provide auditory, visual, and vibrotactile information
  • Installing curb bulbs to reduce crossing distances and improve visibility at key intersections and slow down drivers making right turns with the sharper turn radius

For people biking:

  • We will use green high-visibility pavement to identify bike lanes through driveways and intersections.
  • We are working closely with businesses in the area and can install additional safety features like signage and lights if additional protection is needed through driveways and intersections with higher traffic volumes.
  • The early design improvements will upgrade signals with dedicated turn phases to support the new bike lanes and reduce conflicts
  • We’ve done a full lighting analysis of the corridor and plan to upgrade lighting
  • We are trying to concentrate the driveways into narrow places so that people biking and walking can know where to expect cars coming from and going

Will these roadway changes impact freight routes?

  • We’ve engaged with many industrial stakeholders along the corridor to understand their access and operational needs. The project will not only preserve access on this busy corridor but includes enhancements—in addition to paving—that will be beneficial for freight and other trucks travelling through this corridor.
  • We are working with the Seattle Freight Advisory Board and will address any challenges they see with the design to prevent truck routes needing to move. We know E Marginal Way S is an active freight corridor and this project will preserve access.

Why is the project reducing southbound E Marginal Way S from 2 lanes to 1 lane? How will the lane reduction impact traffic on E Marginal Way S and neighboring streets, considering growing numbers of people and cars?

  • With limited roadway space, it wasn’t possible to add walking and biking facilities for the half mile between 4th Ave S and Ellis Ave S without decreasing the space dedicated to cars and trucks.
  • The lane reduction will also help improve safety on E Marginal Way S. One of the Vision Zero strategies to design safer streets is reducing lanes on multi-lane roads, which helps reduce vehicle speeds and conflict points to prevent crashes.
  • North of the 1st Ave S bridge on E Marginal Way S, traffic counts are much higher (around 42,500 travelers per day) than they are south of the bridge (around 5,500 to 15,500 travelers per day).
    We completed a traffic analysis for reducing E Marginal Way S from 2 to 1 southbound lane between 4th Ave S and Ellis Ave S. The analysis concluded that all intersections would maintain their current levels of service, with only minor delays. Expected delays range from 0 to 10 seconds per vehicle.
  • Because we only expect the lane reduction to increase travel times slightly, driving on main roads will still be faster than cutting through neighborhood streets. The recent Georgetown Healthy Street project added traffic calming measures including speed humps to Carleton Ave S and S Flora St to prevent speeding.

Why is the project removing the right slip lane from E Marginal Way S to 4th Ave S? Will trucks still be able to make this turn?

  • We originally described the changes to the turn lane from northbound E Marginal Way S onto 4th Ave S as the removal of a slip lane, but the 4th Ave S lane is really a wider receiving lane. We are reducing the southeast corner radius and adding a “truck apron” at the northeast corner of the E Marginal Way S and 4th Ave S intersection.
  • This design uses a Vision Zero strategy of designing tighter turns that encourage drivers to slow down. The truck apron allows larger vehicles to drive over a portion of the widened curb to make the turn less tight, which we confirmed with a turn analysis.
  • Below is an example of a truck apron we installed recently at the Airport Way S and S Lucile St intersection.

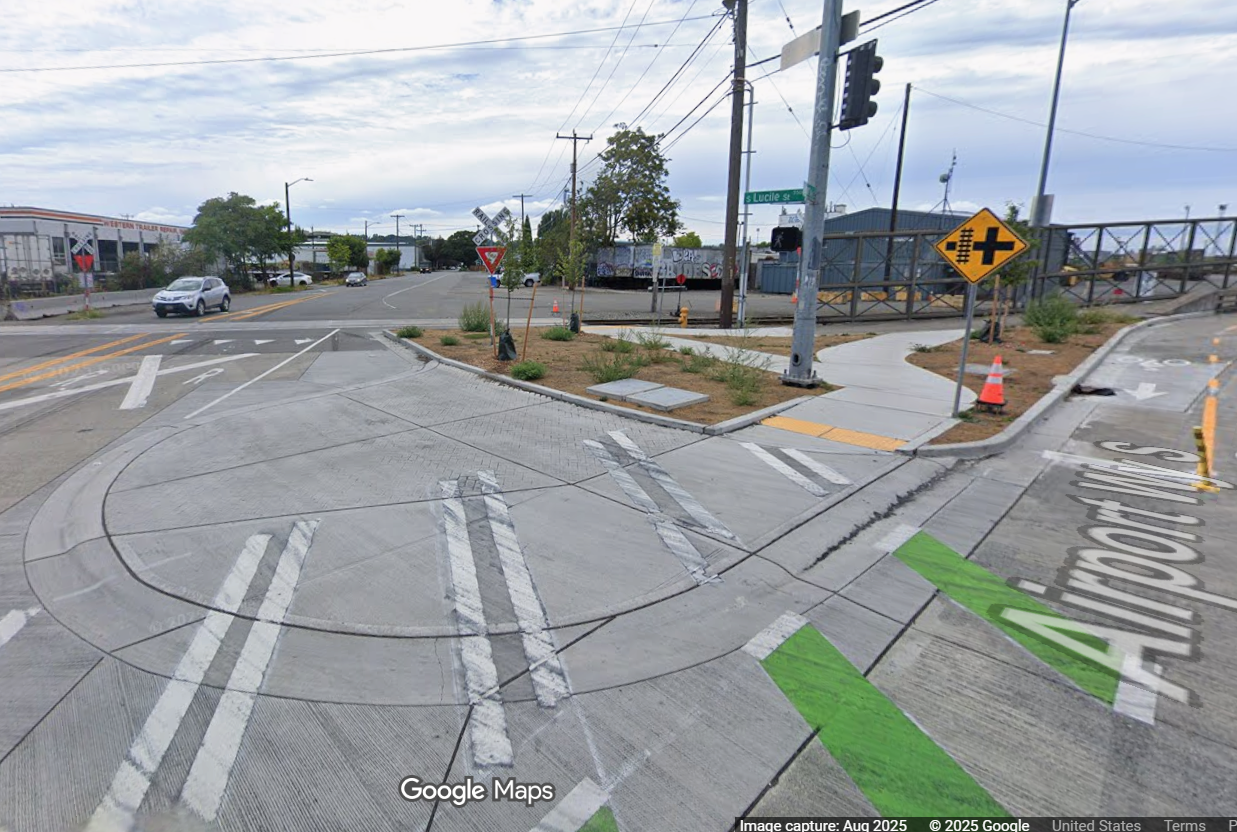

    Example of a truck apron on Airport Way S and S Lucile St

How often are the railroad tracks parallel to E Marginal Way S used? Could this project remove some tracks that aren’t utilized?

  • We are not sure how frequently these tracks are used, but what matters is compatibility, which we will ensure. We're in conversation with Union Pacific Railroad now to understand what impact the project will have on their operations.
  • Unfortunately removing tracks would be out of the scope of this project. It is difficult to work with the railroad and it would likely add time we don't have.

What bus routes are served along this route? Are there going to be a bus/freight lanes along the entire project?

  • This portion of E Marginal Way S is a part of routes 60 and 124.
  • We are not building bus/freight only lanes, but we are working with Metro to explore ways to improve bus operations, including signal hardware upgrades to enable Transit Signal Priority.

How does this project address long-term safety and climate goals? Why is the project lifespan only 10-20 years?

  • During the project's planning phase, we reviewed recommendations from past planning efforts such as the Georgetown Mobility Study, the Seattle Transportation Plan, and the Duwamish Valley Action Plan.
  • The average lifespan of roadway pavement is 15-25 years. Since E Marginal Way S is used by more trucks and other heavy vehicles than other roads, we expect the lifespan of this repaving to be shorter than average. The other improvements to pedestrian, bike, and transit facilities, we expect to be longer lasting, but they may also need upgrades when the next repaving happens.
  • This project adds pedestrian, bike, and transit infrastructure in and between communities that have historically needed to rely on cars. These changes will make getting around without a personal vehicle easier for the people who live and work in Georgetown, South Park, and SODO and will help pave the way for making this area of Seattle less reliant on cars.

What type of trees will be planted and where? How will the new trees planted by the project be maintained?

  • We do not yet have specific tree types planned. The tree type will depend on planting strip width and overhead clearance, with a goal of maximizing tree canopy. The tree types will be ones well suited for the environment, meaning they will be less likely to cause cracking in sidewalks and roadways, and they won’t need to be pruned very often to maintain clearances for trucks, buses, and power lines.
  • The street trees installed by the project are SDOT assets and will be maintained by SDOT Urban Forestry or Seattle City Light, depending on the need for pruning. The contractor will maintain the street trees for one year after they are installed, and then SDOT Urban Forestry will take over establishment care for four more years. Establishment care includes watering in hotter months and establishment pruning to encourage branches to grow away from travel lanes and overhead power lines. Once establishment care is complete, the street trees should be mature enough to survive on their own without supplemental water.

How will the bike lanes be maintained, especially during fall/winter with leaves and rainwater?

  • E Marginal Way S is currently swept weekly as part of sweeping route 105. Because only some street sweepers are small enough to clean bike lanes, the new bike lanes would likely be swept less than weekly but still regularly.
  • Drainage improvements at Corson Ave S, Carleton Ave S, S Myrtle St, Ellis Ave S, and 16th Ave S will help prevent rainwater pooling in the bike lanes.
  • Users can also report broken or damaged bike facilities, including debris, slippery wet leaves or standing water on the bike lane using SDOT’s Find It, Fix It app (or calling 684-ROAD). You can read more details on this SDOT blog post

Schedule

 Schedule graphic showing we are in the early design phase

Planning (complete): We developed the initial plan for paving and street repairs in 2024.

Design (in progress): The project will address community priorities, repair the street, and improve safety. We will share our plans and gather community feedback throughout design. We aim to finalize the design in late 2025.

Construction: We will work with the community to understand their needs. We will share information about the construction schedule and activities. Construction is expected to begin in early 2027 and take about one year.

Funding

This project is funded by the voter-approved 2024 Seattle Transportation Levy. To learn more, visit seattle.gov/transportation/levy. It is also partially funded through a Puget Sound Regional Council (PSRC) Preservation Grant.
