Lake Washington Boulevard Renovations

Updated: July 9, 2025

Summer 2025

Lake Washington Boulevard is a valued space and vital connection for communities in Southeast Seattle and beyond. Your input played a key role in shaping the design of the safety and access improvements in this project. Learn more here: Outreach Summary for the Lake Washington Boulevard Renovations Project

Next Steps

The City of Seattle is implementing this project through a phased approach to effectively manage resources, expedite improvements, and address community needs in a timely and comprehensive manner. This strategy allows the City to deliver immediate, high-priority safety and accessibility upgrades while planning for long-term enhancements across the entire three-mile corridor within the available budget. The phased approach also enables the City to leverage matching funds from the Washington State Transportation Improvement Board’s Complete Streets grant and supports an incremental, adaptive process that prioritizes continuous monitoring and data-driven adjustments to ensure the project’s success.

See below for the project snapshot map:

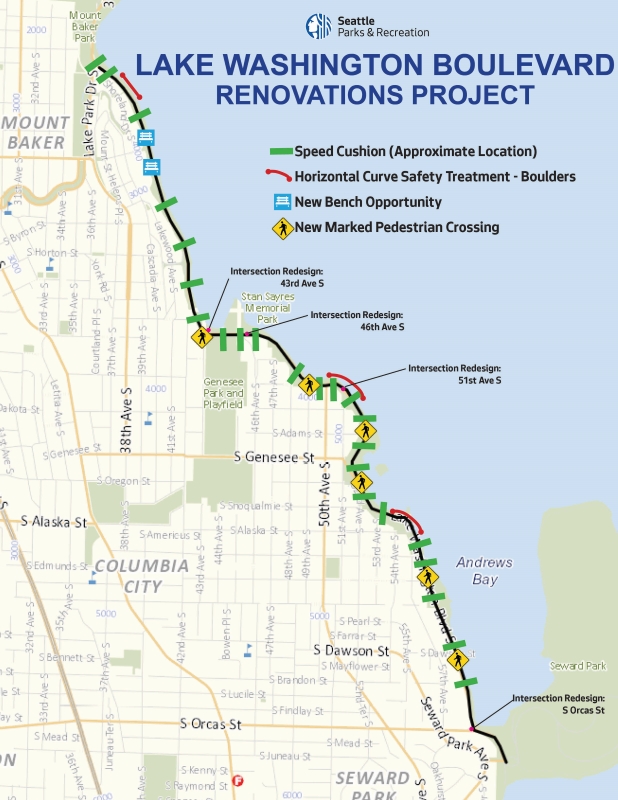

A map of the Lake Washington Boulevard Renovations Project and the planned improvements for Lake WA Blvd from Mount Baker Beach to Seward Park.

Anticipated Construction Schedule

Phase 1: Fall 2024 - Complete

  • 43rd Ave S
    • Marked pedestrian crossing
    • 2 speed cushions (both approaches to intersection)
  • 46th Ave S
    • Painted curb extensions
    • 2 speed cushions (both approaches to intersection)
  • 49th Ave S
    • Marked pedestrian crossing
    • 2 speed cushions (both approaches to intersection)
  • Curve between 50th Ave S and 51st Ave S
    • Tree planting to replace missing trees
  • S Adams St
    • Marked pedestrian crossing
    • 2 speed cushions (both approaches to intersection)
  • S Genesee Way
    • Marked pedestrian crossing
    • Painted walkway connection through parking lot
    • Bike corral
    • 2 speed cushions (both approaches to intersection)
  • Curve between 53rd Ave S and S Alaska St
    • Tree planting to replace missing trees
  • S Ferdinand St
    • Marked pedestrian crossing (north leg)
    • 2 speed cushions (both approaches to intersection)

Phase 2: Summer/Fall 2025

  • Lake WA Boulevard Pathway (Mount Baker Beach to Genesee Park)
    • Asphalt pavement repairs to address tripping hazards caused by tree roots.
  • Lake Park Dr S
    • Updated reflective crosswalk signage
    • Boulders between trees (illegal parking deterrent)
  • Lake Washington Fishing Pier (North mile)
    • Two new benches
  • 43rd Ave S
    • Paved walkway from S Genessee St to Lake Washington Boulevard
  • 51st Ave S
    • Paint and post curb extensions
  • S Adams St
    • Paved walkway connection to Lake Washington Boulevard Pathway
  • S Dawson St
    • Marked pedestrian crossing

Phase 3:

SDOT is currently monitoring traffic volume and speed counts on locations studied as part of the Rainer Ave S Vision Zero & Lake Washington Blvd Keep Moving Street Data Analysis. Data will be considered before phase 3 improvements begin.

Location

Lake Washington Boulevard

Budget

$404,000 is allocated to this project for planning, design and construction from the Seattle Parks District Fund. Additional funding is secured through leveraging SPR’s partnership with the Seattle Department of Transportation (SDOT).

The Washington State Transportation Improvement Board (TIB) has awarded this project the Complete Streets grant match funding.

Project Description

In partnership with the SDOT and the community, SPR is leading and managing the implementation of improvements to Lake Washington Boulevard to calm traffic and enhance safety for everyone who visits and travels along Lake Washington Boulevard.

This project is informed by the Short-Term Recommendations in the Lake Washington Boulevard Visioning Process and Recommendations Report created by the Lake Washington Boulevard Task Force.

To learn more, visit the Seattle Department of Transportation's Lake Washington Boulevard project webpage. 

Schedule

Preliminary Community Outreach: Summer 2023
Design Development: Fall 2023 – Winter 2024
Design Review & Engagement: Spring 2024 - Summer 2024
Construction: Phased approach, Summer 2024 – Summer 2026

Community Participation

Thank you to everyone who spoke with our project team and shared their input. Please view the Community Outreach Summary for additional information.
